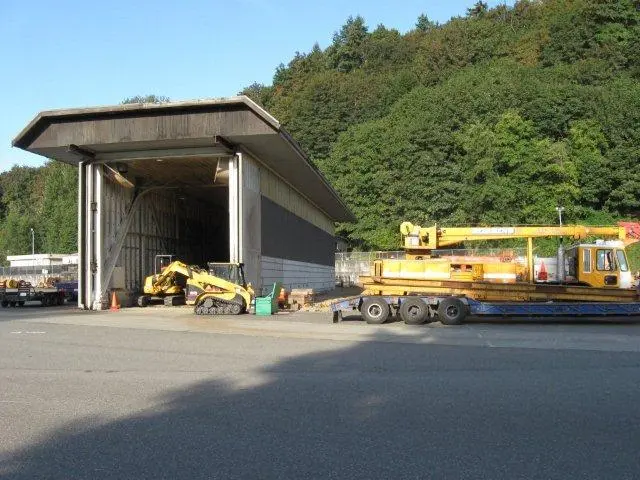

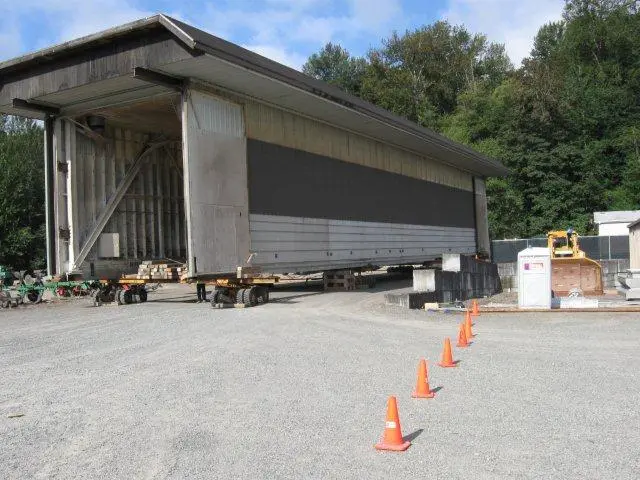

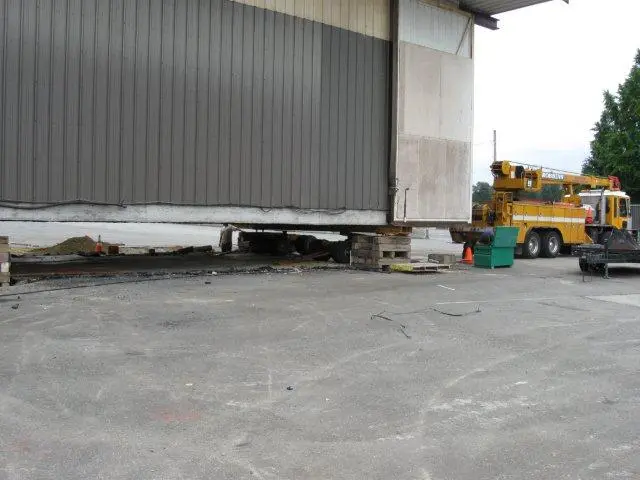

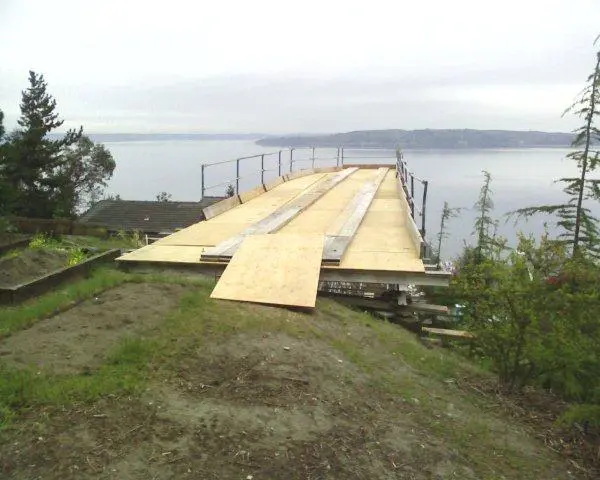

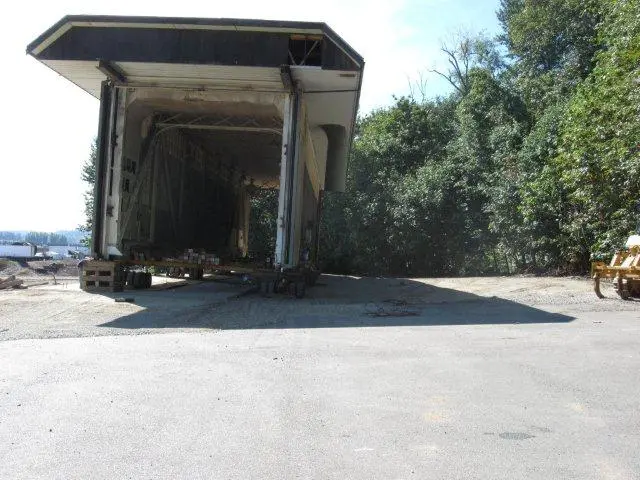

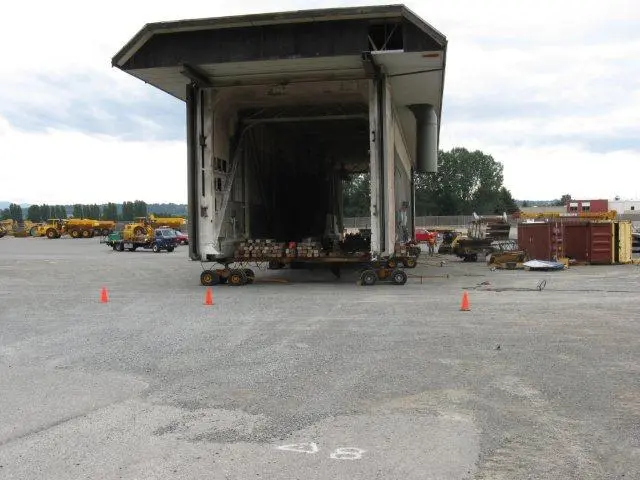

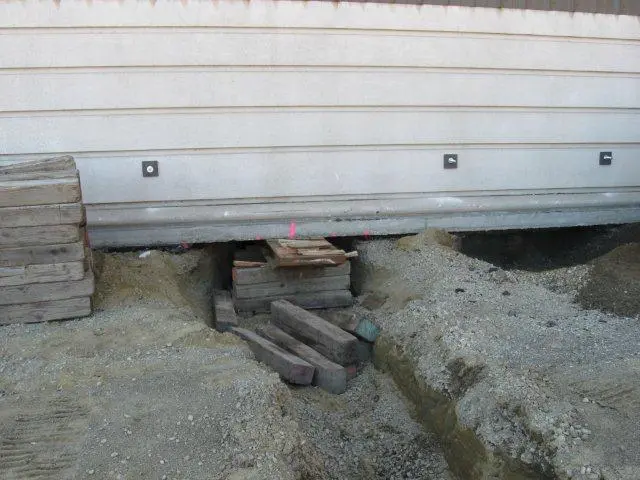

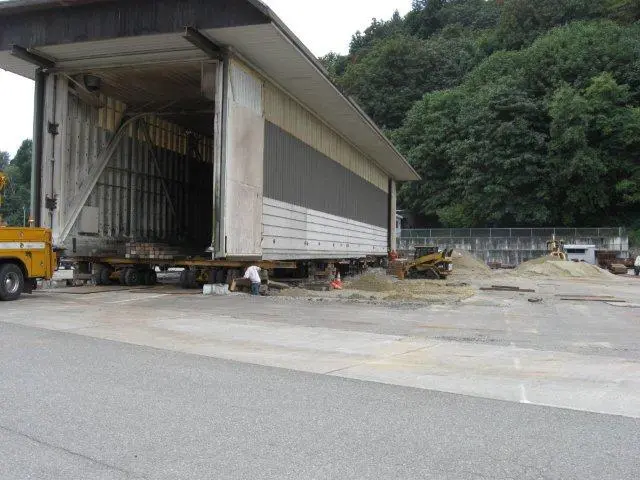

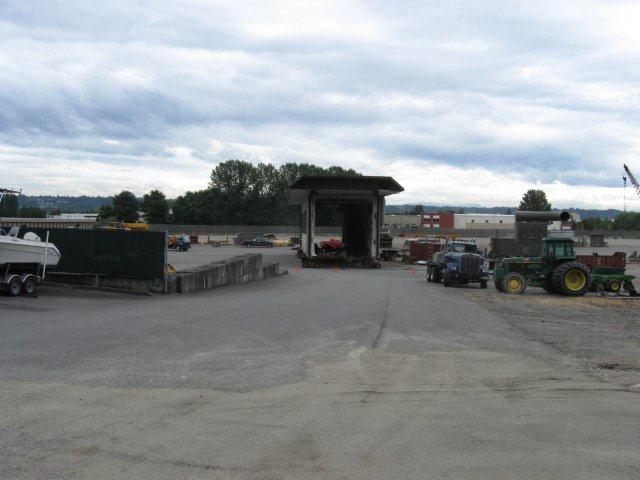

300 Ton Bridge

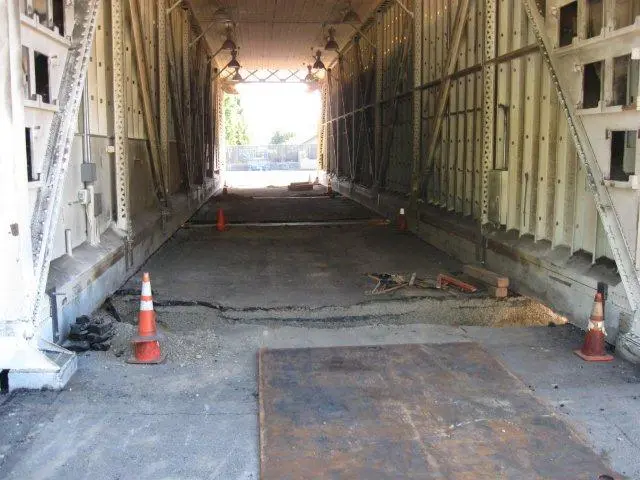

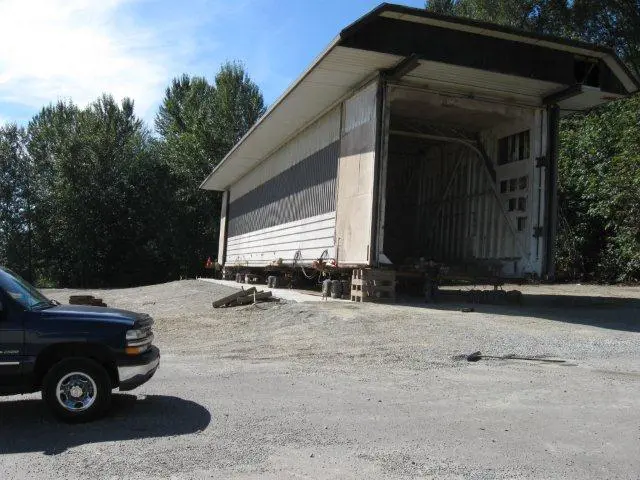

It needed to be moved to allow for new road construction, so we were contracted to move it approximately .5 of a mile and place it on a new slab.

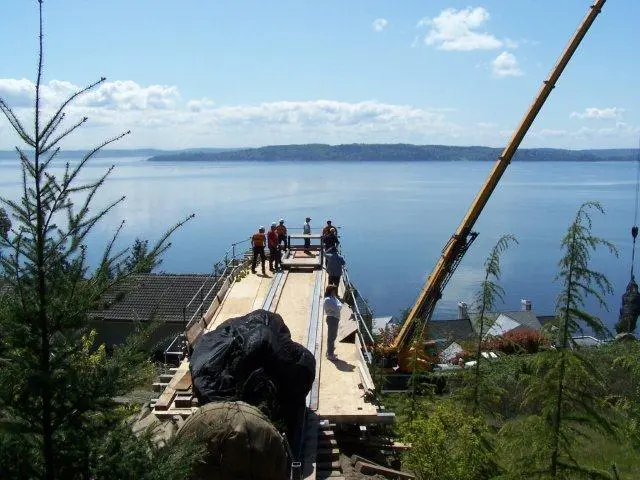

The challenge was to move it up the hill and turn it on a compound angle with no room for error.

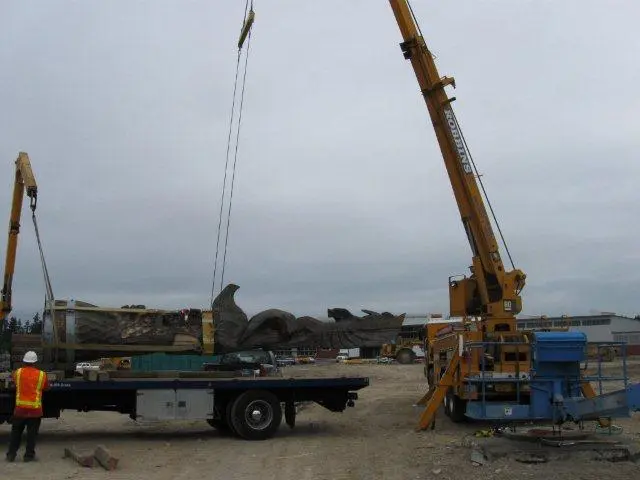

Centurylink Field Gallery
Totem Pole Gallery
Sculpted Wood Carving Gallery

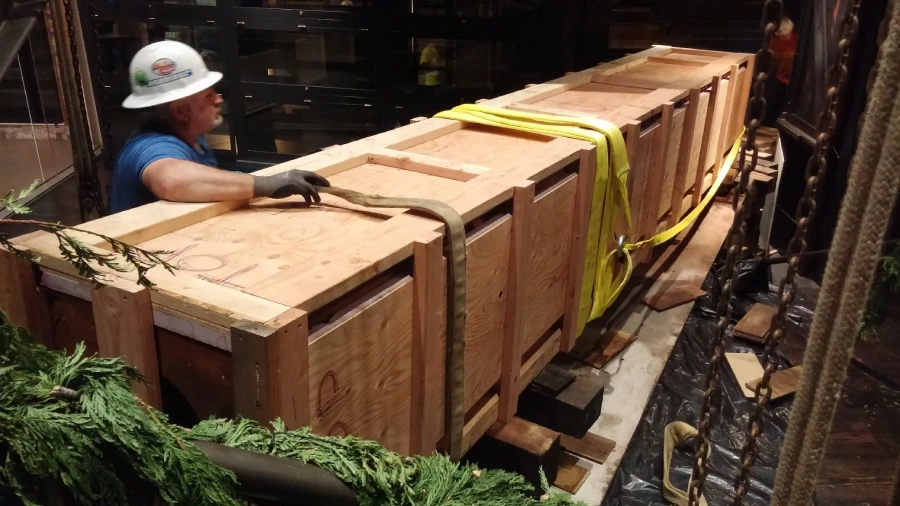

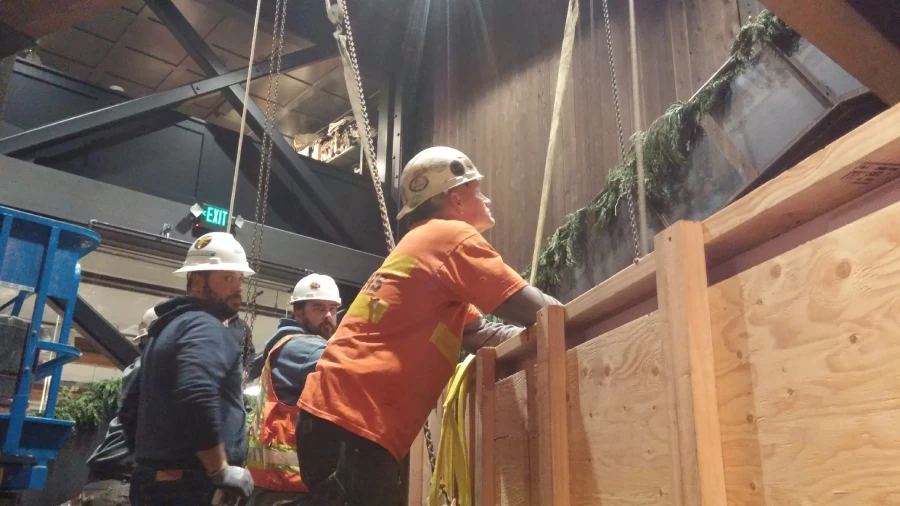

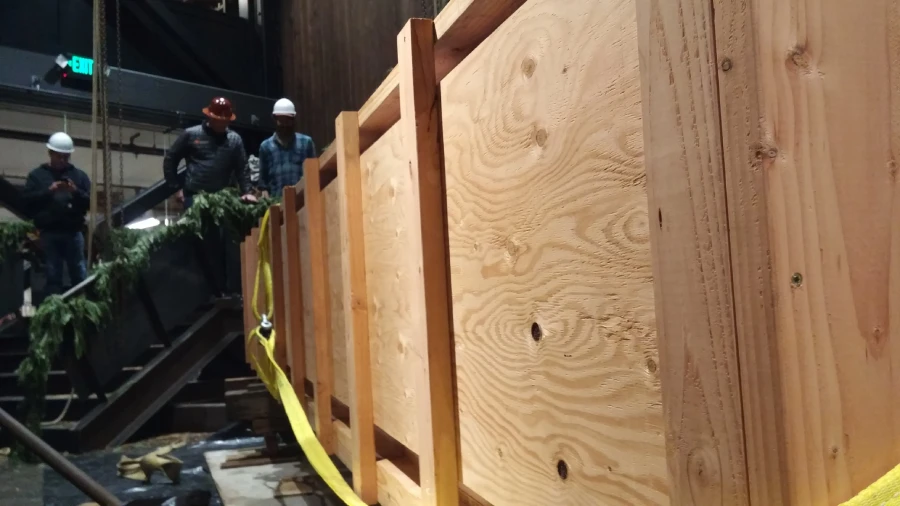

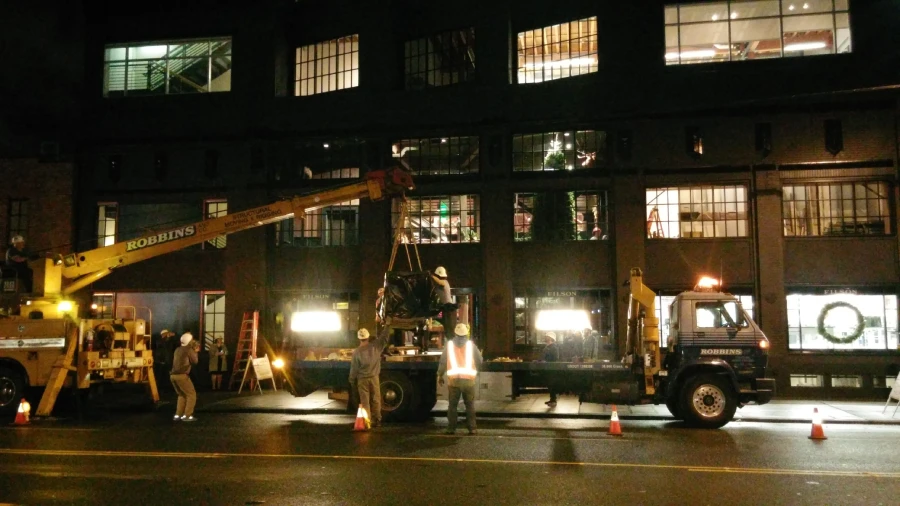

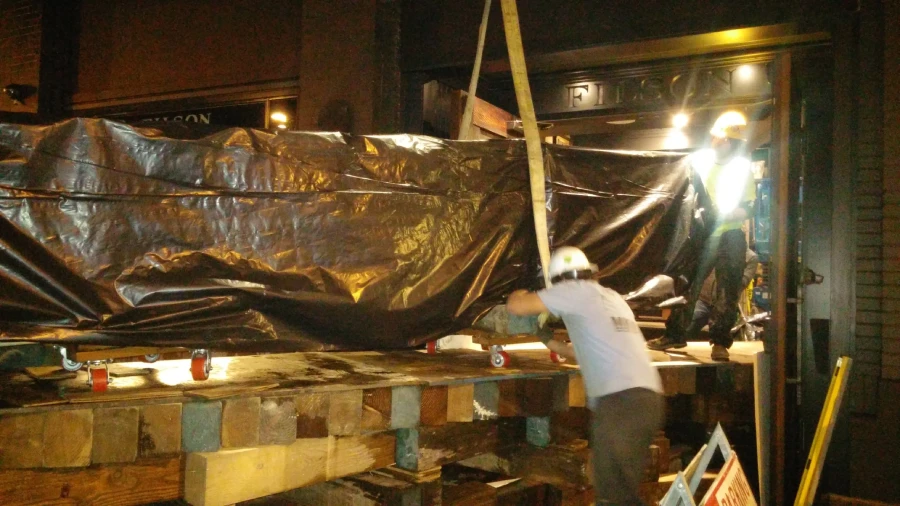

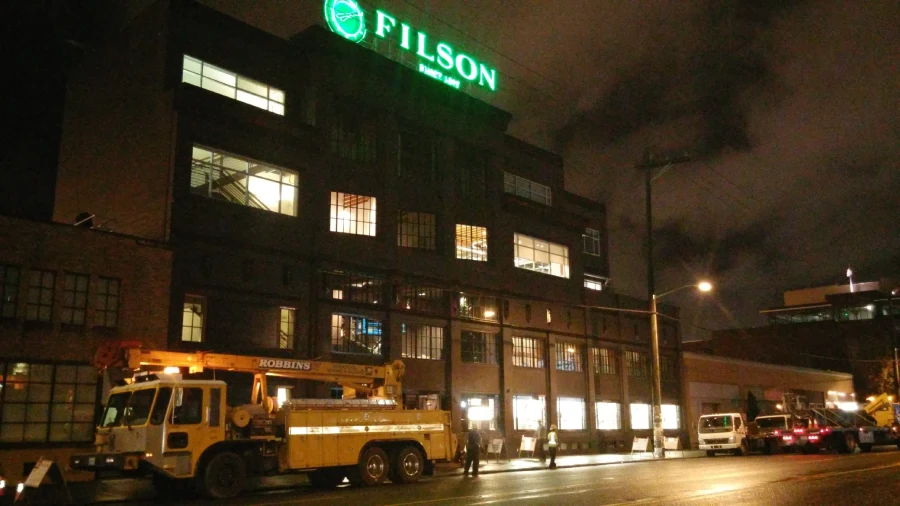

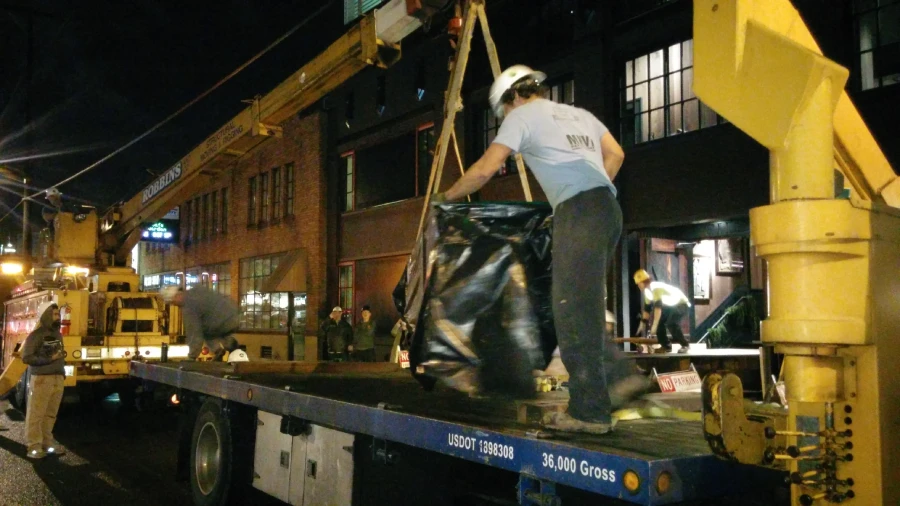

When we were chosen to do the project on a Saturday, it had to be installed that Thursday. We met with Filson again on a Monday and sent drawings for brackets for engineering. By Tuesday, received engineer approval and ordered the steel for fabricating the brackets. On Wednesday, we drove to Orcas Island to load the 18.5 foot sculpture. Then on Thursday, we loaded all the rigging equipment, assembled the crew and mobilized to the site for installation of the giant structure.

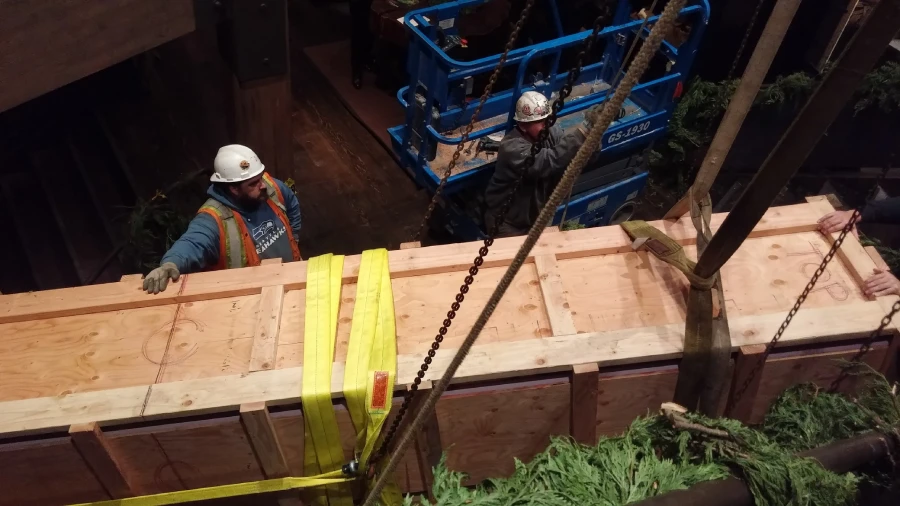

It took four months for artist and wood sculptor, Aleph Geddis, to design and carve this one-of-a-kind piece of art for the Filson flagship retail store in Seattle. Utilizing hand-made tools and an unique style formed through an appreciation of North West Coast Native Art and travels around the world, Aleph, with the help of his carving team, has created a 18.5 foot testament to the wild spirit of the Northwest.

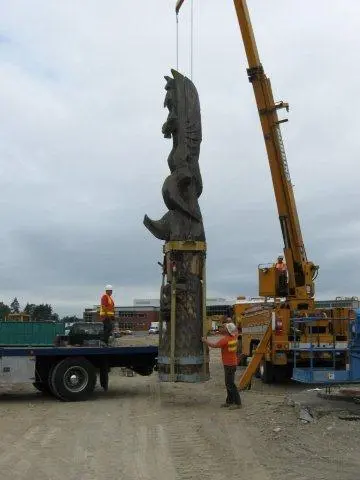

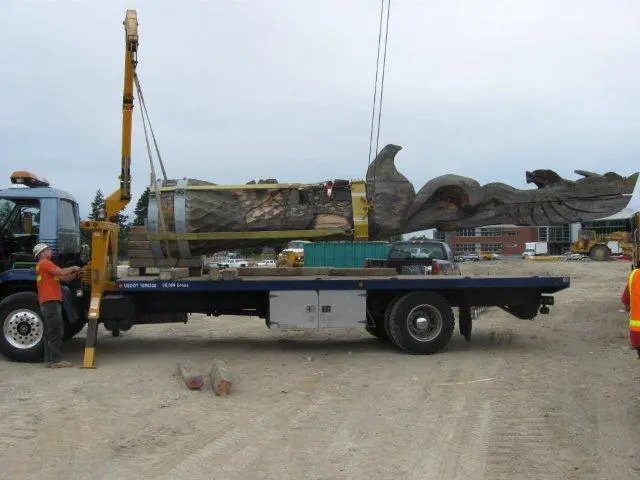

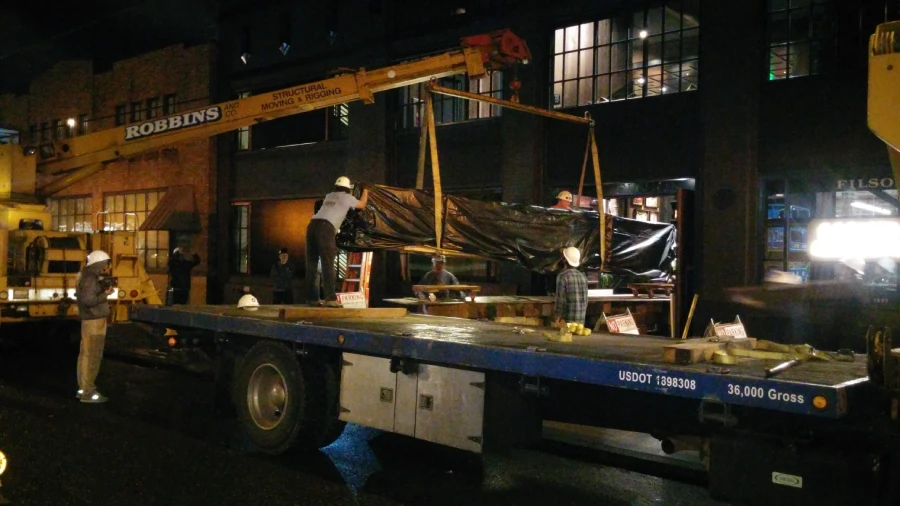

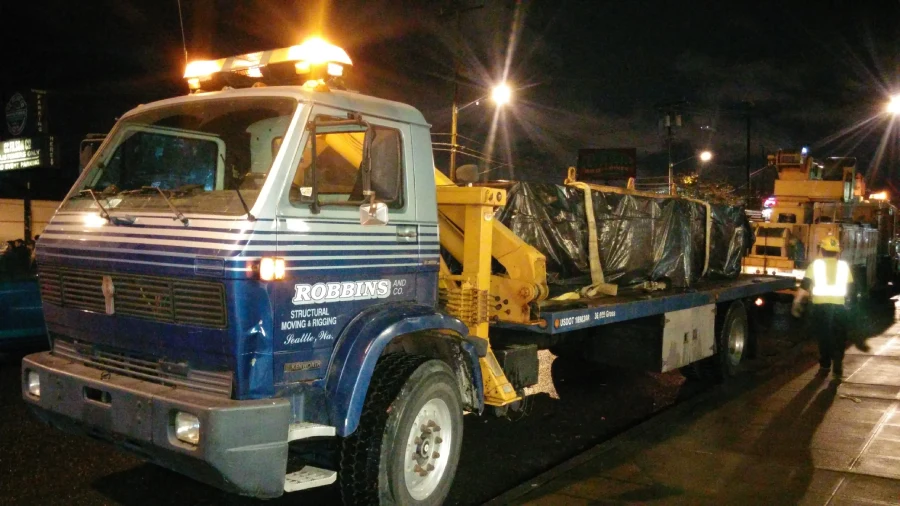

Aleph Geddis, Artist and Wood Sculptor
Spruce Goose Gallery

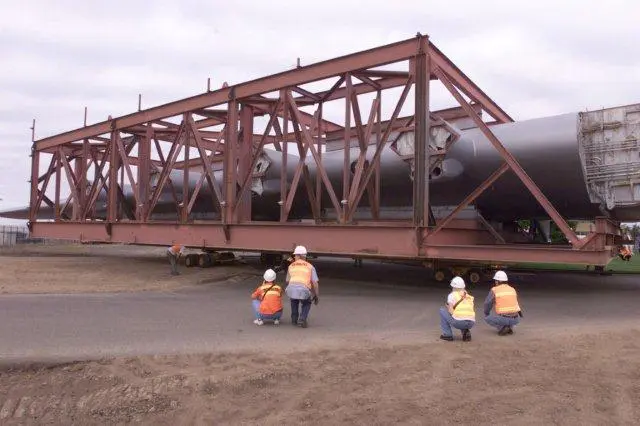

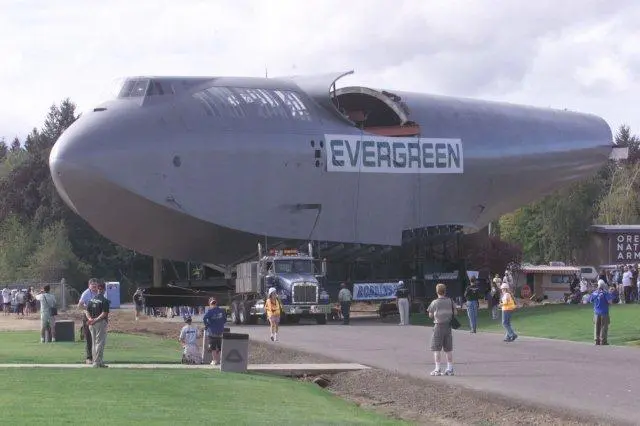

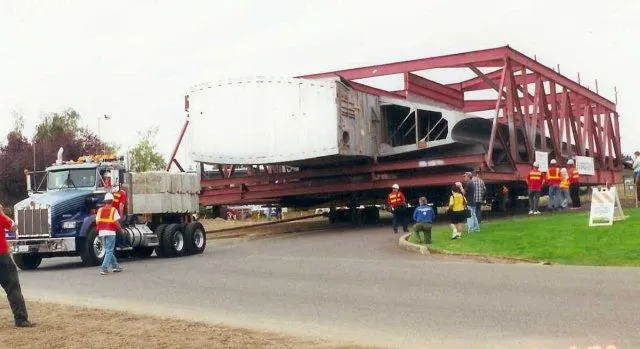

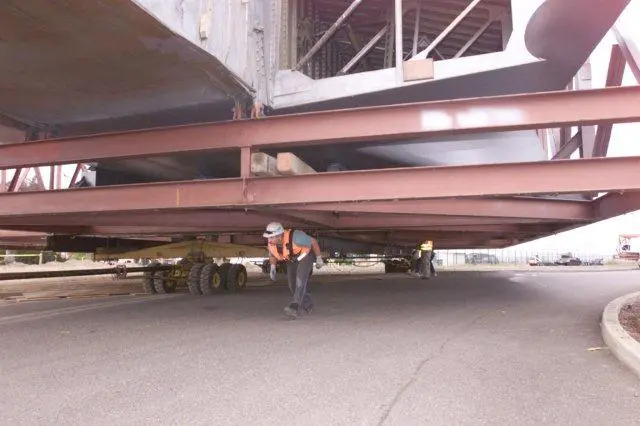

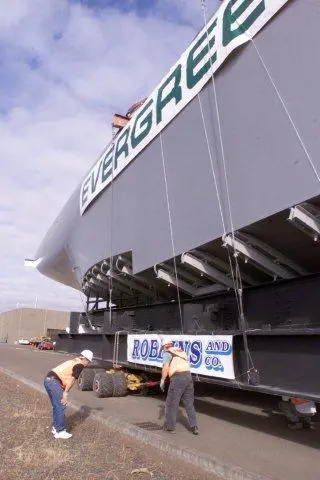

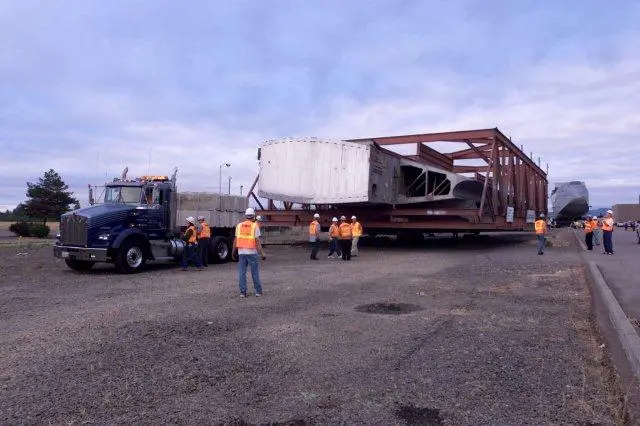

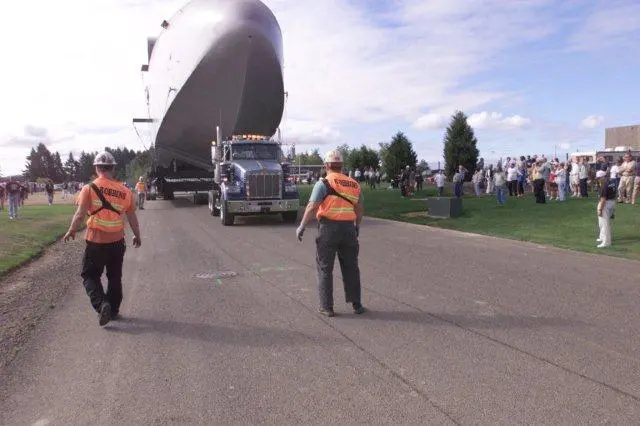

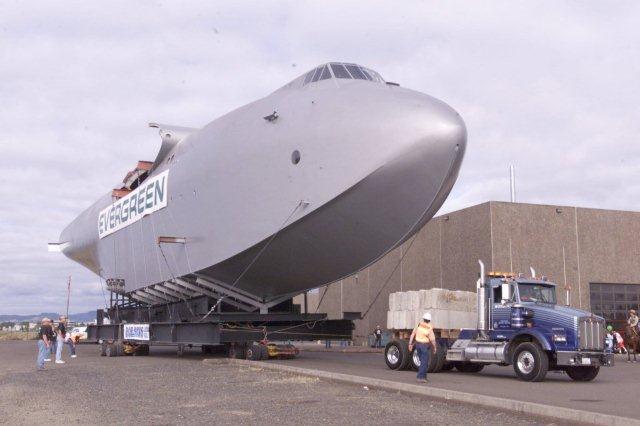

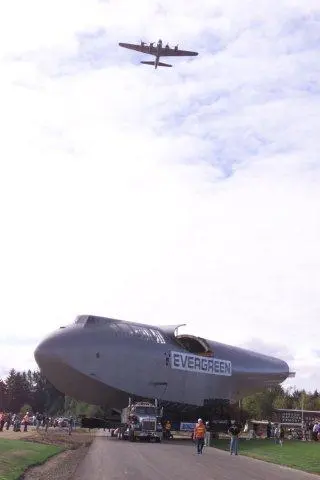

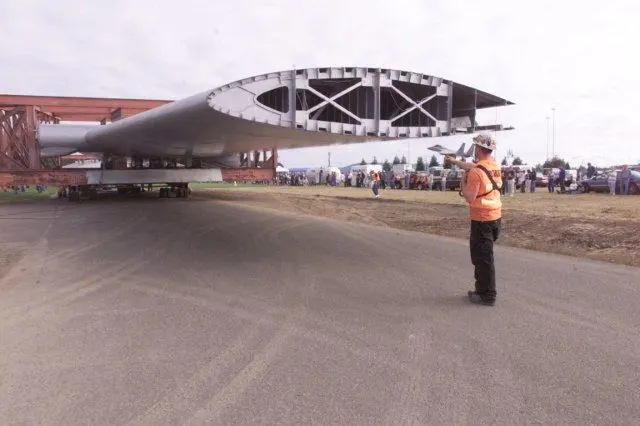

The timing had to be expedited due to the fact part of the move went across a highway, so that highway had to be closed. The gigantic plane was dismantled into 4 different sections, with the fuselage weighing over 400 tons alone! The Spruce Goose had been delivered to the Evergreen Airport and Robbins and Co needed to carefully maneuver it over a mile to its new home at the Evergreen Aviation & Space Museum. There was an air show happening at the same time and became a big news event.
Tree Replacement Gallery

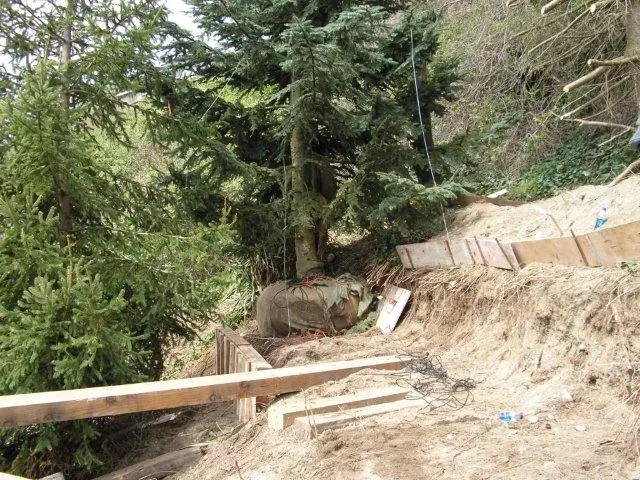

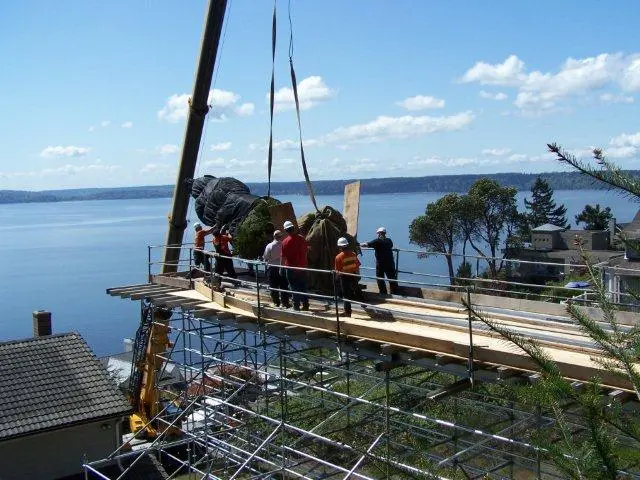

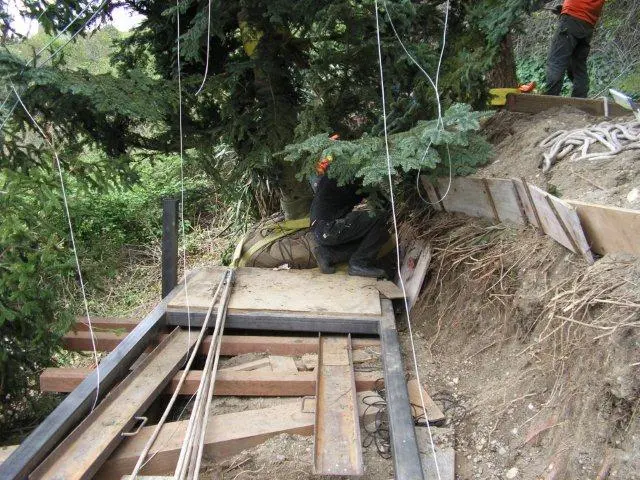

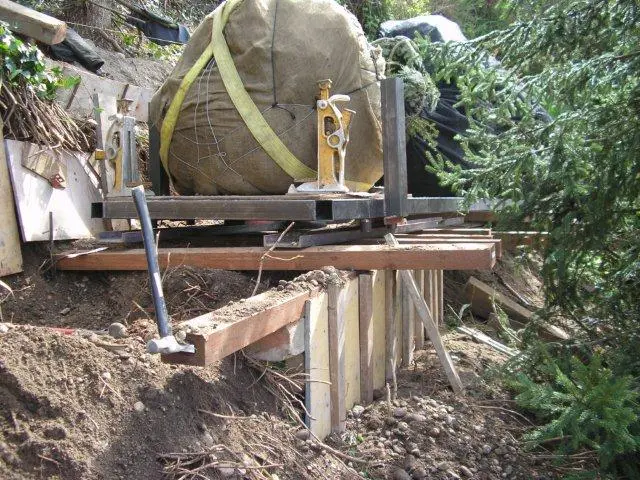

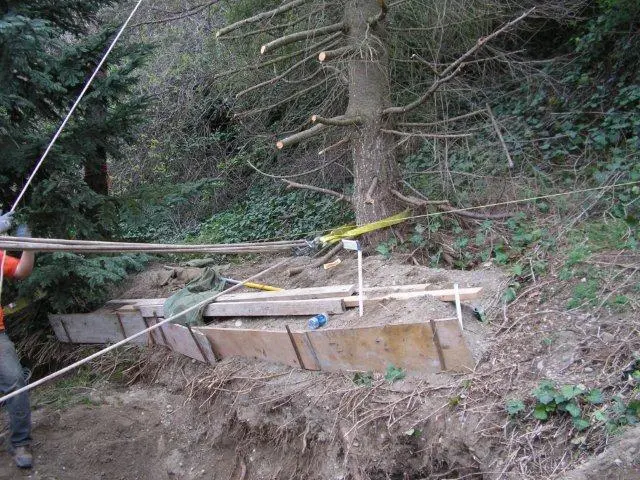

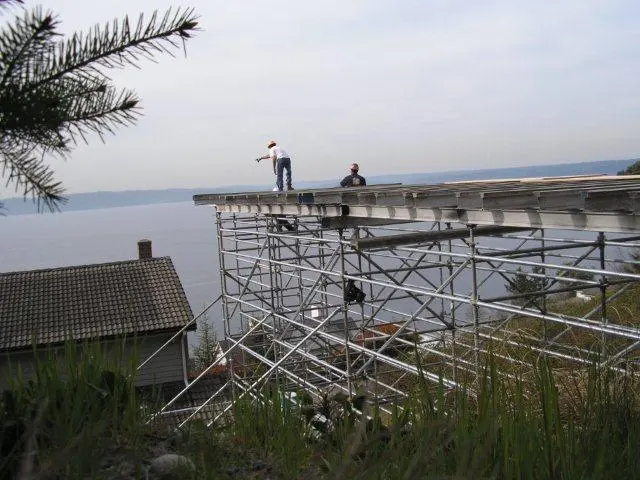

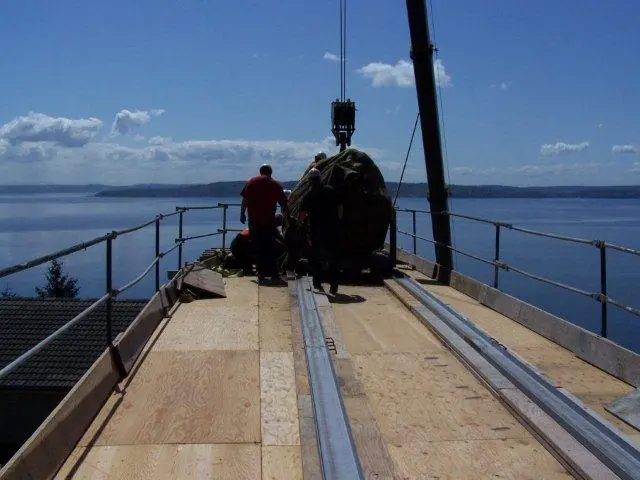

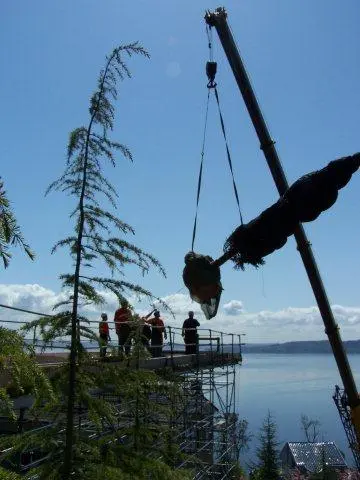

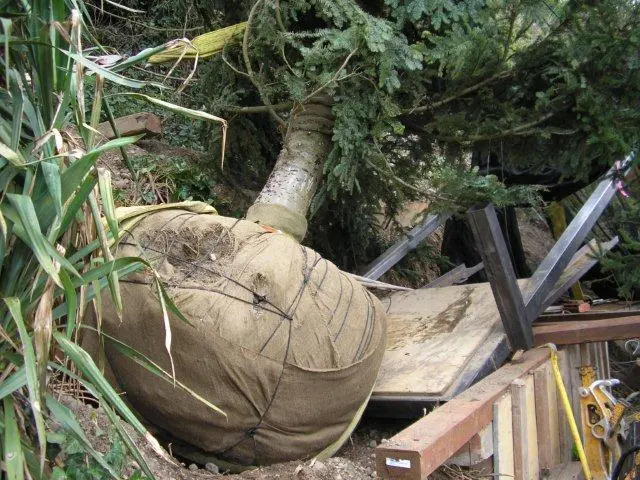

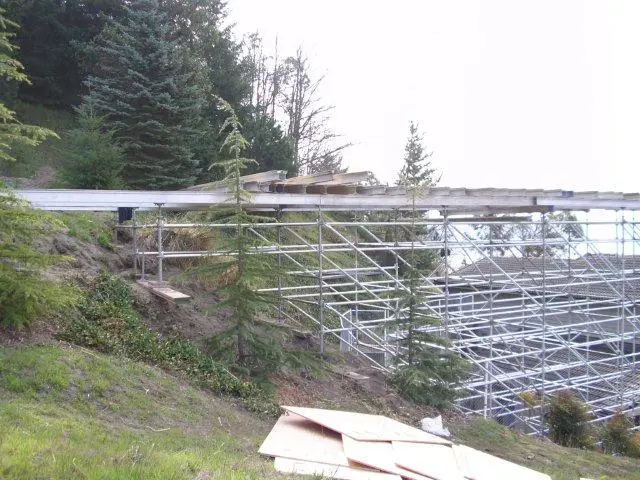

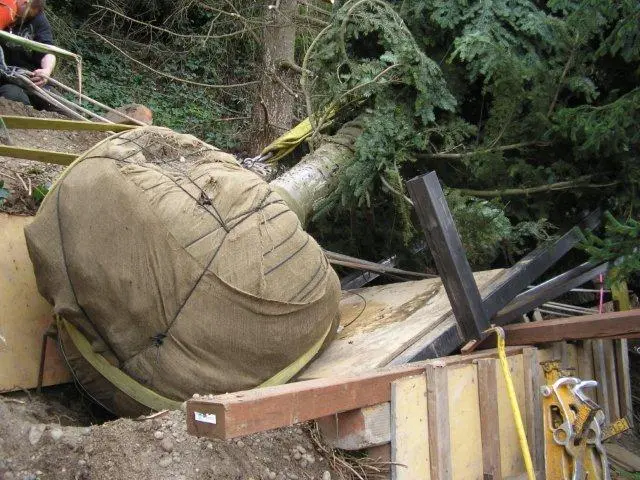

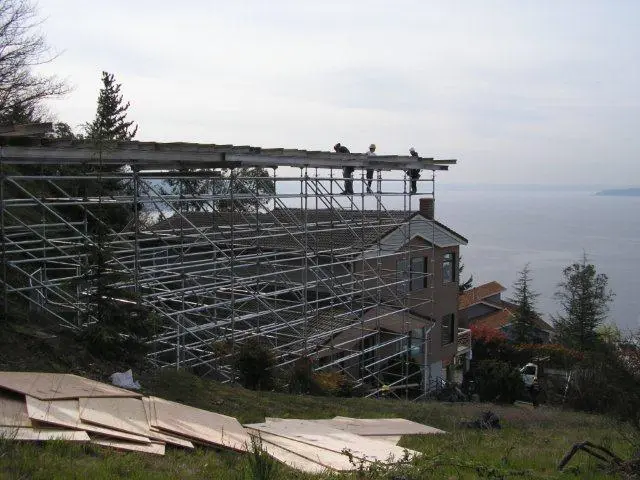

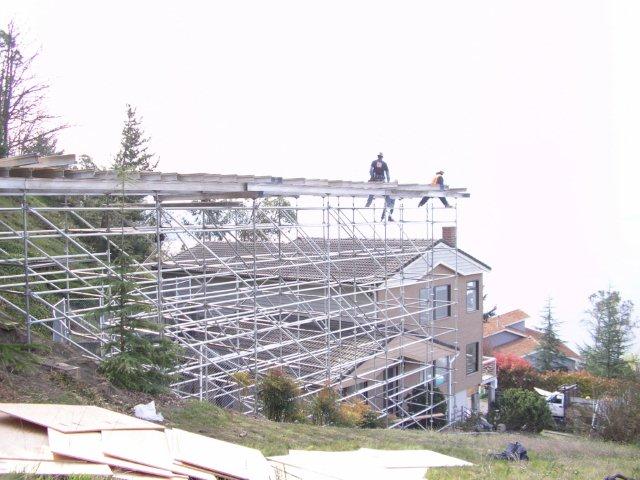

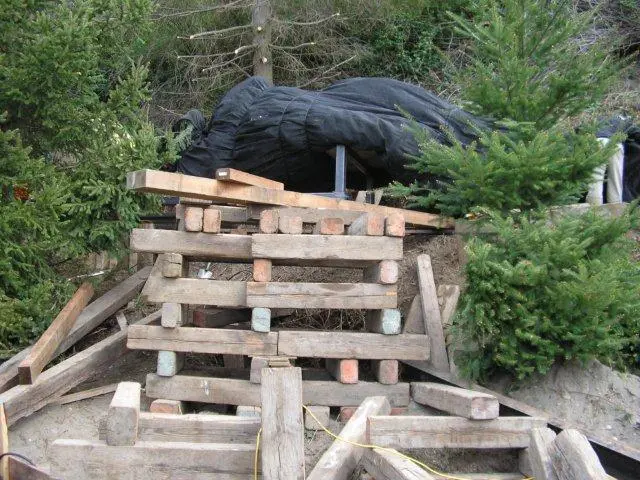

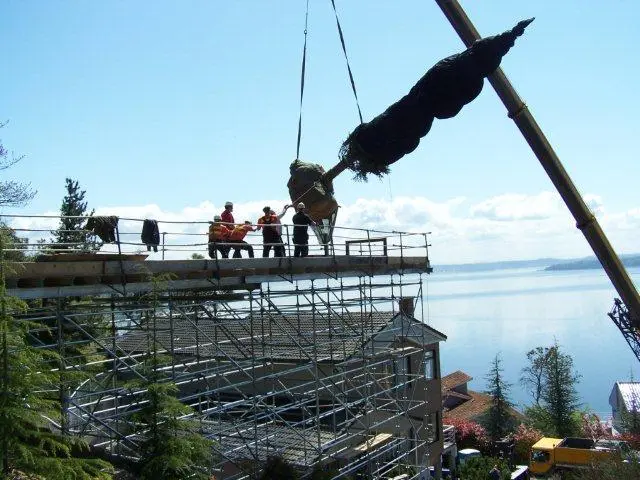

Several ideas were tossed around form a large enough crane to reach the site, but cost and access to the site would not accommodate such a large crane. We looked into using a helicopter but the cost and the safety factor were too high. We were not able to use any equipment to carry the trees due to how steep the terrain was. We choose to go with structural scaffolding and roll the trees into the hillside. But that only got the trees part of the way because we had to jack them up about 8’ ft and continue rolling them into the hillside. We also had to move one of the trees sideways approximately 30’ ft, and stand them up without the use of any power equipment. The project from start to finish took about six days.

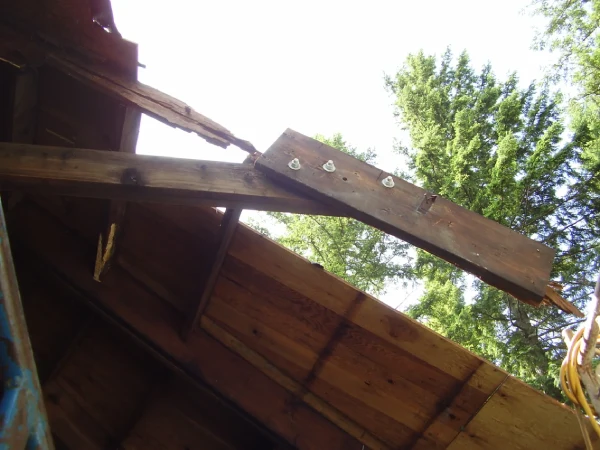

Camp Waskowitz Gallery

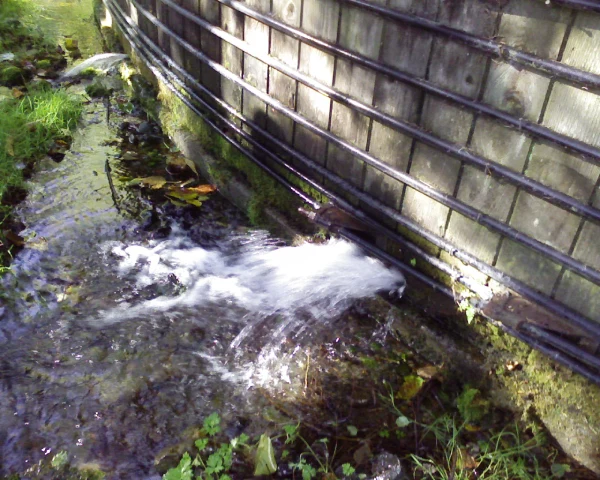

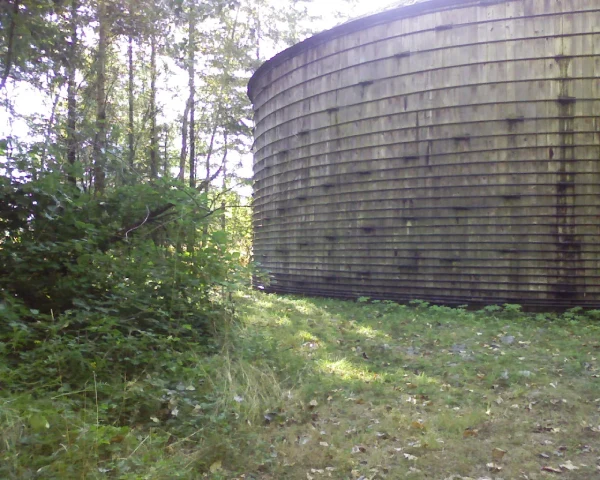

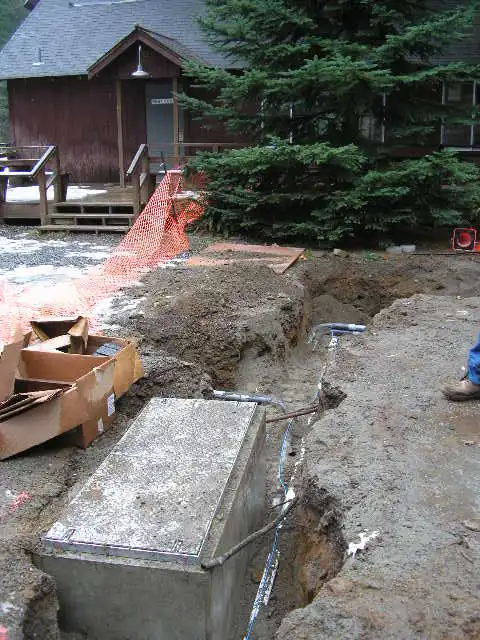

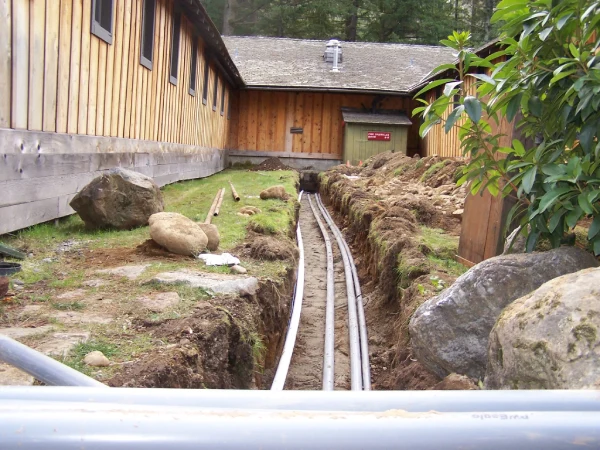

Tank was feeding the drinking water system as well as the fire hydrants water supply. Prior to fixing the tank, two separate systems needed to be built, so that drinking water and fire suppressions for the hydrant water could be pumped through a pump house. And while beginning the project, we used three 10,000 gallon tanks to hold water during construction.

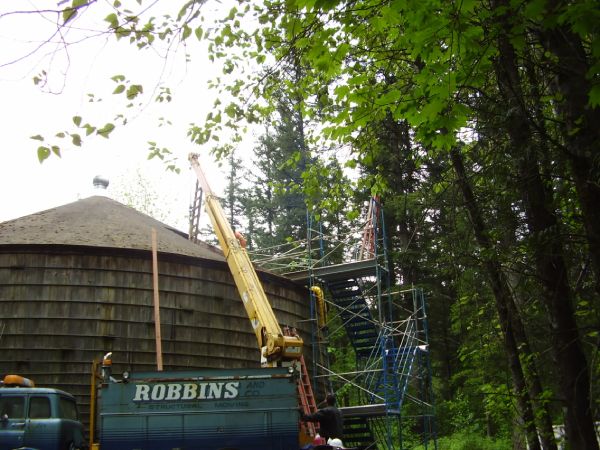

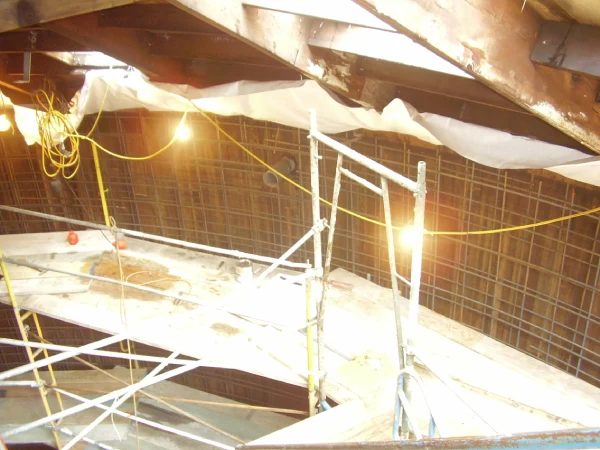

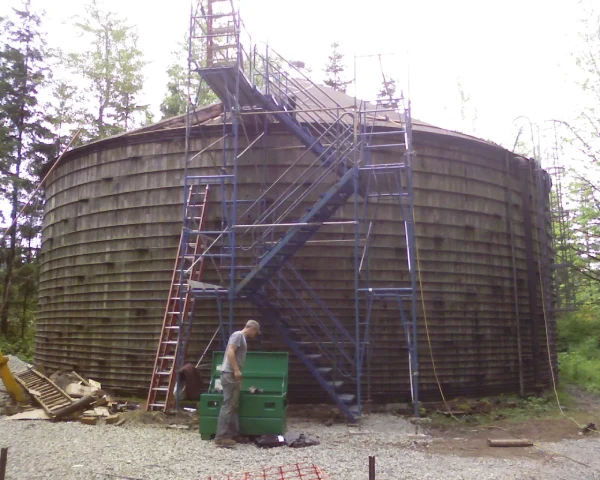

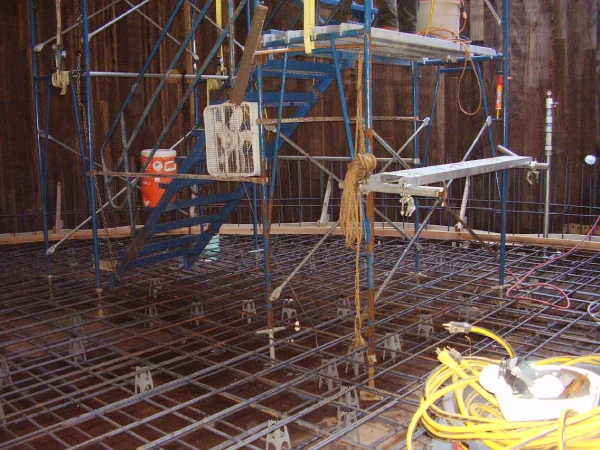

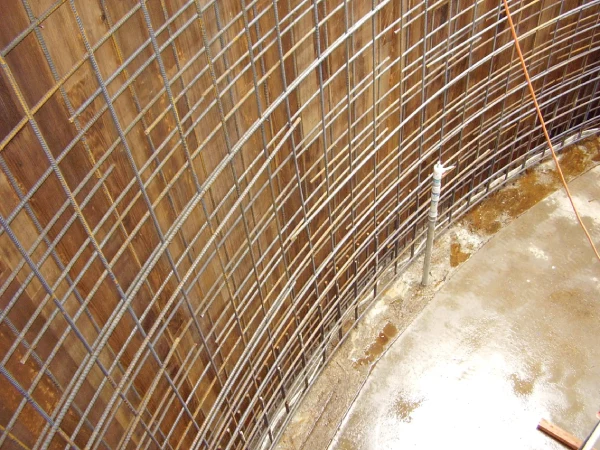

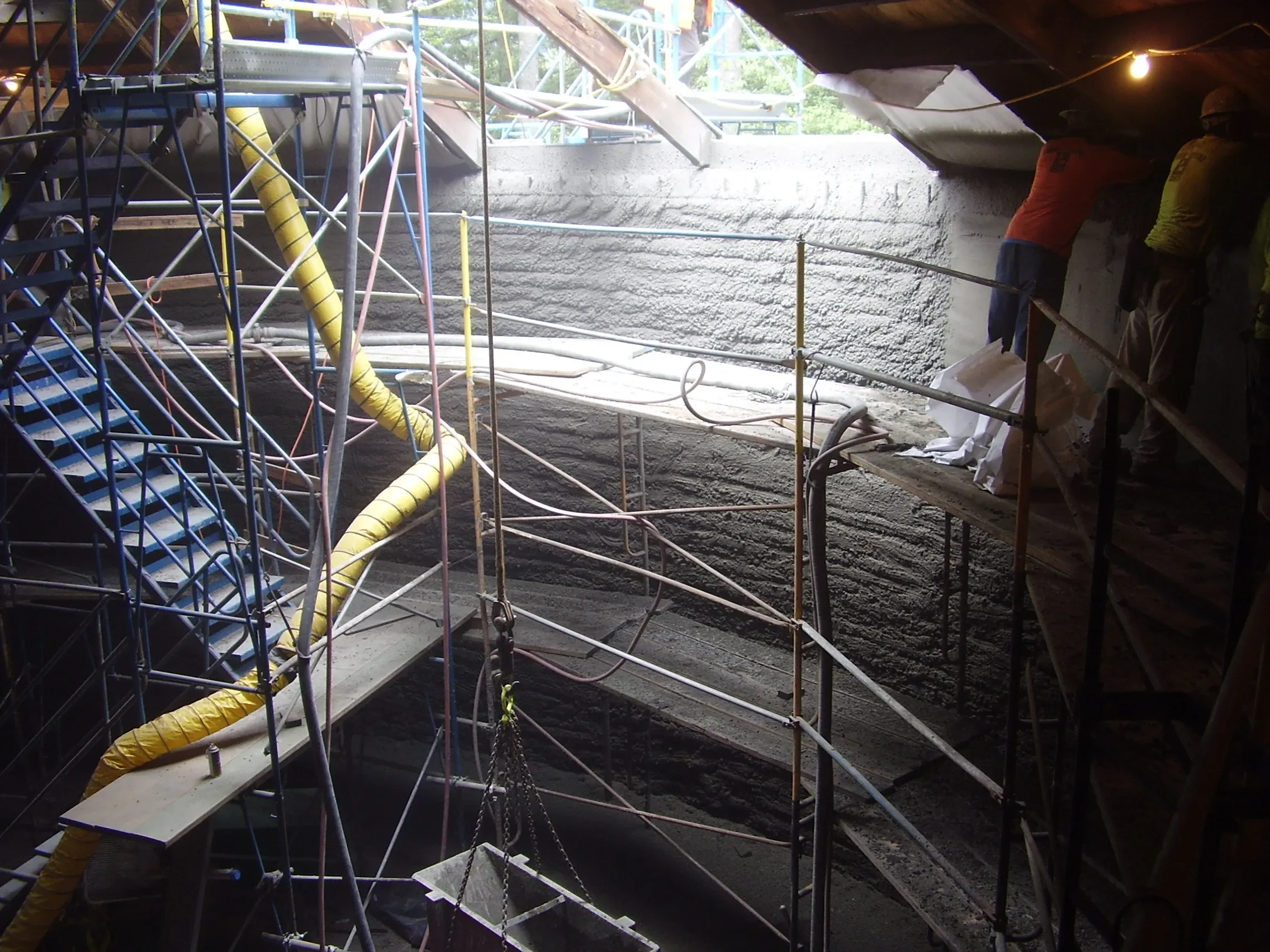

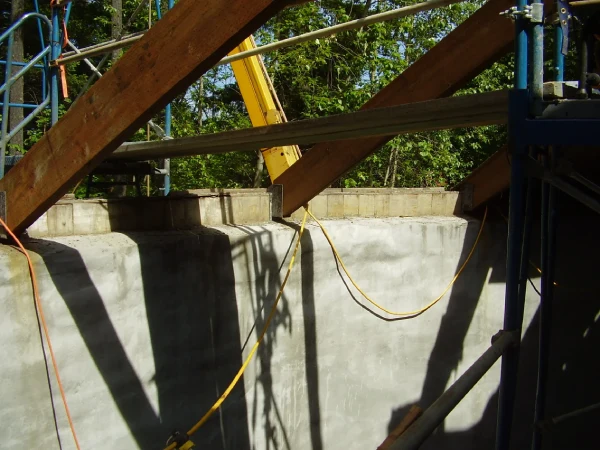

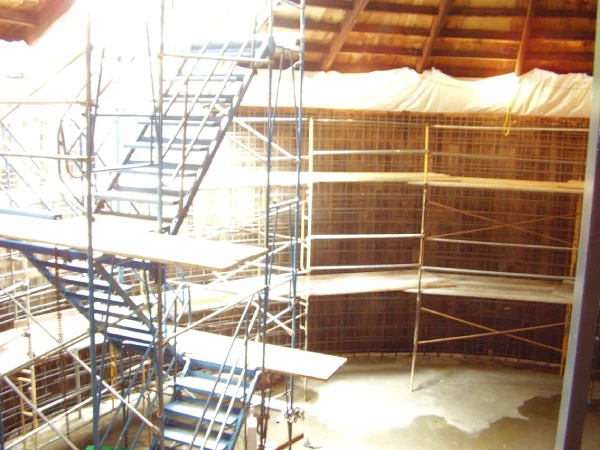

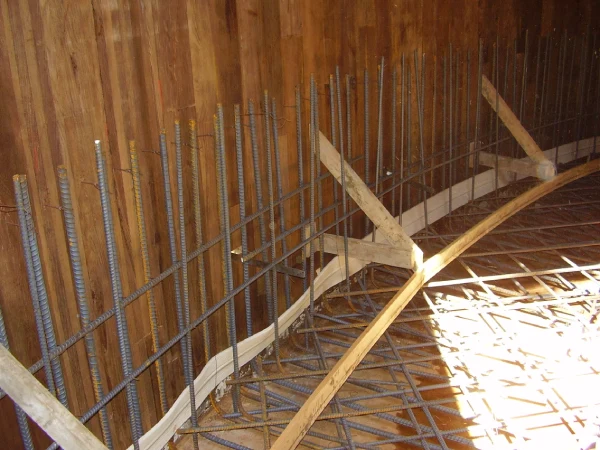

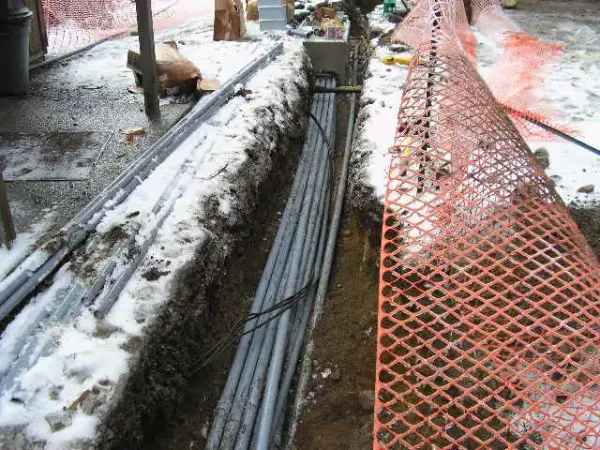

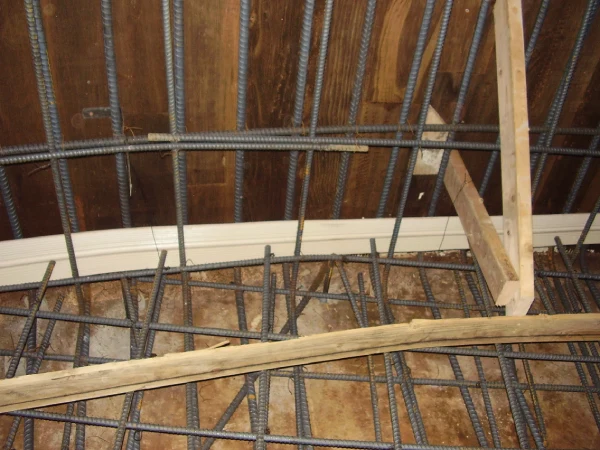

The camp wanted to keep exterior of tank, which was made of red cedar wood, so the best solution was to pour a 24 inch concrete pad, and shotcrete the walls 12 inches thick. Approximately half the roof had to be ripped off and replaced. Also, While installing the drinking water system also installed conduit and vaults for future high voltage and data systems.
